Learn

Can You Fail a Blower Door Test?

“Pass” and “fail” depend entirely on what target you're being tested against — here's how that works.

Homeowners and builders booking a blower door test often ask a version of the same question: “what happens if I fail?” The honest answer is that there’s no single universal pass mark. Whether a result counts as a pass or a fail depends entirely on what target applies to your project — and in many cases, there’s no formal target at all.

14 min read

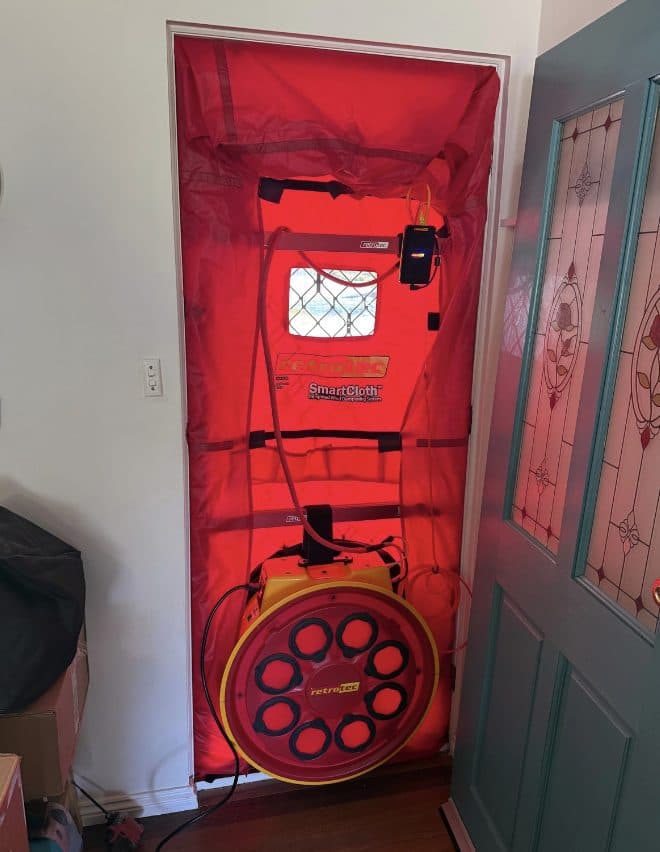

Blower door test on site at Nairne, Adelaide Hills
A documented blower door test at Nairne, Adelaide Hills — see the full result.

Key takeaways

  • There is no single national “pass” or “fail” ACH50 number in Australia. What counts as passing depends on the specific target: Passive House certification, a builder's specification, or a project-specific goal.
  • NCC 2022 doesn't set a maximum ACH50 — testing under 5 ACH50 triggers a mechanical ventilation requirement, not a “fail”.
  • Passive House certification requires ≤0.6 ACH50 — the closest thing to a true pass/fail line in Australian high-performance building.
  • Most “failed” results are caused by a handful of common, findable and fixable leakage areas.
  • If a target is missed, the usual next step is leak-hunting, targeted sealing, and a retest — not a rebuild.

1. What does “passing” a blower door test actually mean?

A blower door test itself doesn’t pass or fail anything — it simply measures a building’s airtightness and reports a result, expressed as ACH50. Whether that result counts as a “pass” depends entirely on whether there was a target to measure it against.

Three very different reasons to test

A blower door test might be run to certify Passive House compliance (strict pass/fail), to verify a contractual specification (pass/fail against a written number), or purely diagnostically on an existing home with mould or comfort complaints (no pass/fail at all — just information to guide repairs).

2. There’s no universal pass mark

Passive House certification

Fixed target? Yes — ≤0.6 ACH50, fixed and non-negotiable

If missed: Certification withheld until remediation and a passing retest

NCC 2022 (general compliance)

Fixed target? No maximum ACH50 to “pass”

If missed: Testing under 5 ACH50 triggers a mechanical ventilation requirement — not a fail

Builder / contract specification

Fixed target? Sometimes — if written into the contract

If missed: A specification non-compliance, handled between builder and client

Existing home diagnostic testing

Fixed target? No

If missed: Nothing to fail — the test documents performance and locates leaks

The takeaway: before you can know whether a result “passed,” you need to know what it was being tested against. This should be settled before the test, not after.

3. Passive House targets

Passive House is the one context in Australian high-performance building where there’s a genuinely fixed pass/fail line: ≤0.6 ACH50, tested per Passive House Institute protocol. A Passive House project that tests above 0.6 ACH50 at final test simply cannot be certified until further sealing work brings it under the threshold.

Because the margin for error is so small, Passive House projects almost always include a mid-construction (pre-lining) test as standard practice — see preparing for a blower door test.

HiPer Haus field note

HiPer Haus has supplied and commissioned MVHR for several certified and near-certified Passive House projects in South Australia, including a Certified Passivhaus at Thebarton and the Passivhaus Plus display home at Mount Barker (both built by Enduro Builders).

4. Builder and contract specifications

Many project specifications now nominate a specific ACH50 target as a measurable performance requirement — independent of any regulatory requirement. In this context, “failing” means the tested result doesn’t meet the number written into the contract.

Reading the fine print

“Best endeavours to achieve ≤5 ACH50” and “shall achieve ≤5 ACH50, tested and documented at handover” are very different commitments. If airtightness performance matters to you, ask which wording applies to your contract.

5. Existing homes — testing without a target

For most existing homes, there’s usually no formal target at all. The test is run diagnostically: to establish a baseline ACH50, and to physically locate specific leakage paths using a smoke pencil or thermal camera. The useful output isn’t a pass/fail verdict — it’s a prioritised list of leaks to address.

6. Common leakage areas found during testing

Downlights

Direct penetration into the roof space, often with gaps around the fitting

Typical fix: IC-rated, gasketed downlights or airtight cover boxes

Exhaust fans

Ducting and ceiling penetrations often poorly sealed; leaky backdraught dampers

Typical fix: Properly sealed ducting, quality dampers, correct external termination

Cornices and skirtings

Gaps between plasterboard and structure at ceiling/wall and wall/floor junctions

Typical fix: Caulking or tape at the airtight layer before fitting

Window and door reveals

Gaps between frame and structure where wrap wasn't properly taped

Typical fix: Correctly taped membrane laps around every frame

Service penetrations

Cables and pipes passing through the air barrier unsealed

Typical fix: Grommets, sealant or purpose-made airtight sleeves

Roof access hatches

Often just a lid resting in an opening, no gasket

Typical fix: Gasketed, latching hatch covers

Evaporative cooling ducts

Large uninsulated, unsealed ducts direct to outside air

Typical fix: Sealed, insulated ducting with a well-fitted damper

HiPer Haus field note

On a pre-renovation test of an existing home at Nairne, the combined leakage measured 1,149 cm² (0.115 m²) — equivalent to a single round hole about 38 cm across, noticeably larger than an A4 sheet of paper (roughly 624 cm²). That’s a real, documented result on an untreated existing home.

7. What happens if you don’t meet your target

  1. 1Depressurise and leak-hunt: the tester uses a smoke pencil (and sometimes a thermal camera) to physically locate where air is entering.
  2. 2Prioritise and seal: leaks are ranked by size and accessibility, then sealed with tape, sealant, or gaskets appropriate to the detail.
  3. 3Retest: once sealing work is complete, the blower door test is repeated to confirm the target has been met.

The cost and disruption depends heavily on when the first test happened. A pre-lining test that finds leaks while the airtight layer is still exposed is quick and cheap to fix. A final test at practical completion is considerably more disruptive and expensive to remediate.

Want leaks found while they’re still cheap to fix?

Book a pre-lining test →

8. Retesting — process, timing and cost

Retesting is common, not exceptional — particularly on Passive House projects, where hitting ≤0.6 ACH50 on the first attempt is achievable but not guaranteed. Where possible, schedule the retest soon after remediation, while the trades who did the sealing work are still engaged.

9. What a blower door test report includes

A proper report includes the headline ACH50 result, the raw Q50 airflow figure and building volume used, the test direction(s), building details, conditions on the day, a leakage summary with photos, and — for Passive House or NCC-relevant testing — certifier-ready documentation. Ask for this level of detail up front.

Frequently asked questions

Is there a legal minimum ACH50 a new home in Australia must achieve?

No. NCC 2022 doesn't set a maximum ACH50 a home must pass. It requires mechanical ventilation meeting a minimum calculated airflow rate once a home tests under 5 ACH50.

What ACH50 do I need for Passive House certification?

0.6 ACH50 or lower, tested per Passive House Institute protocol. This is a fixed requirement with no flexibility.

Can a blower door test damage my home?

No, the test uses moderate, controlled pressures well within what buildings are designed to withstand.

What if my new home tests above 5 ACH50, do I fail?

No, there is no fail at 5 ACH50 under general NCC pathways. It means mechanical ventilation meeting the minimum calculated airflow rate is required.

How much does it cost to fix a leaky result?

It depends on what's found and when. Leaks found pre-lining are inexpensive to seal; leaks found at final test after linings are up cost more to fix.

Should I test during construction or just at the end?

Both, ideally. A pre-lining test lets leaks be found and fixed cheaply; a final test documents the completed result.

Can an existing home fail a blower door test?

Not formally, unless a specific target has been set. Most existing-home testing is diagnostic rather than pass or fail.

Does my builder have to guarantee a specific ACH50?

Only if it's written into the contract or specification.

What are the most common reasons homes miss their target?

Downlights, exhaust fan ducting, cornice and skirting junctions, window and door reveal sealing, and service penetrations.

Can I seal leaks myself before a retest?

For accessible leaks before lining, yes in consultation with your builder. For leaks behind finished linings, professional remediation is usually required.

How long does a retest take?

Similar to the original test, typically a couple of hours on site, varying with building size and number of leaks being verified.

Does a fail affect my home insurance or resale value?

The result itself isn't reported to insurers, but unresolved moisture or mould issues stemming from inadequate ventilation could be relevant at resale inspection.

Booking a test and want to understand your target first?

Book a blower door test with HiPer Haus, or get in touch to discuss the right airtightness target for your project.
